February 2021 Update

[cs_content][cs_element_section _id=”1″ ][cs_element_layout_row _id=”2″ ][cs_element_layout_column _id=”3″ ][cs_text id=”toc” class=”cs-ta-center” style=”background: rgba(255,255,255,.5);”]

  February 2021

[/cs_text][cs_element_text _id=”5″ ][/cs_element_layout_column][/cs_element_layout_row][/cs_element_section][cs_element_section _id=”6″ ][cs_element_layout_row _id=”7″ ][cs_element_layout_column _id=”8″ ][cs_element_text _id=”9″ ][cs_element_line _id=”10″ ][/cs_element_layout_column][/cs_element_layout_row][cs_element_layout_row _id=”11″ ][cs_element_layout_column _id=”12″ ][cs_element_text _id=”13″ ][/cs_element_layout_column][cs_element_layout_column _id=”14″ ][cs_element_text _id=”15″ ][/cs_element_layout_column][/cs_element_layout_row][cs_element_layout_row _id=”16″ ][cs_element_layout_column _id=”17″ ][cs_element_button _id=”18″ ][/cs_element_layout_column][/cs_element_layout_row][/cs_element_section][cs_element_section _id=”19″ ][cs_element_layout_row _id=”20″ ][cs_element_layout_column _id=”21″ ][cs_element_text _id=”22″ ][cs_element_line _id=”23″ ][/cs_element_layout_column][/cs_element_layout_row][cs_element_layout_row _id=”24″ ][cs_element_layout_column _id=”25″ ][cs_element_text _id=”26″ ][/cs_element_layout_column][/cs_element_layout_row][cs_element_layout_row _id=”27″ ][cs_element_layout_column _id=”28″ ][cs_element_button _id=”29″ ][/cs_element_layout_column][/cs_element_layout_row][/cs_element_section][cs_element_section _id=”30″ ][cs_element_layout_row _id=”31″ ][cs_element_layout_column _id=”32″ ][cs_element_creative_cta _id=”33″ ][/cs_element_layout_column][/cs_element_layout_row][cs_element_layout_row _id=”34″ ][cs_element_layout_column _id=”35″ ][cs_element_button _id=”36″ ][/cs_element_layout_column][/cs_element_layout_row][/cs_element_section][cs_element_section _id=”37″ ][cs_element_layout_row _id=”38″ ][cs_element_layout_column _id=”39″ ][cs_element_image _id=”40″ ][cs_element_image _id=”41″ ][cs_element_image _id=”42″ ][cs_element_image _id=”43″ ][cs_element_image _id=”44″ ][cs_element_image _id=”45″ ][cs_element_image _id=”46″ ][cs_element_image _id=”47″ ][cs_element_image _id=”48″ ][cs_element_image _id=”49″ ][cs_element_image _id=”50″ ][cs_element_image _id=”51″ ][cs_element_image _id=”52″ ][cs_element_image _id=”53″ ][cs_element_image _id=”54″ ][cs_element_image _id=”55″ ][cs_element_image _id=”56″ ][cs_element_image _id=”57″ ][cs_element_image _id=”58″ ][/cs_element_layout_column][/cs_element_layout_row][cs_element_layout_row _id=”59″ ][cs_element_layout_column _id=”60″ ][cs_element_button _id=”61″ ][/cs_element_layout_column][/cs_element_layout_row][/cs_element_section][/cs_content][cs_content_seo]  February 2021

CONTENTS
Project Achievements
Project Goals
Did You Know?
Photos

Project Achievements

Site

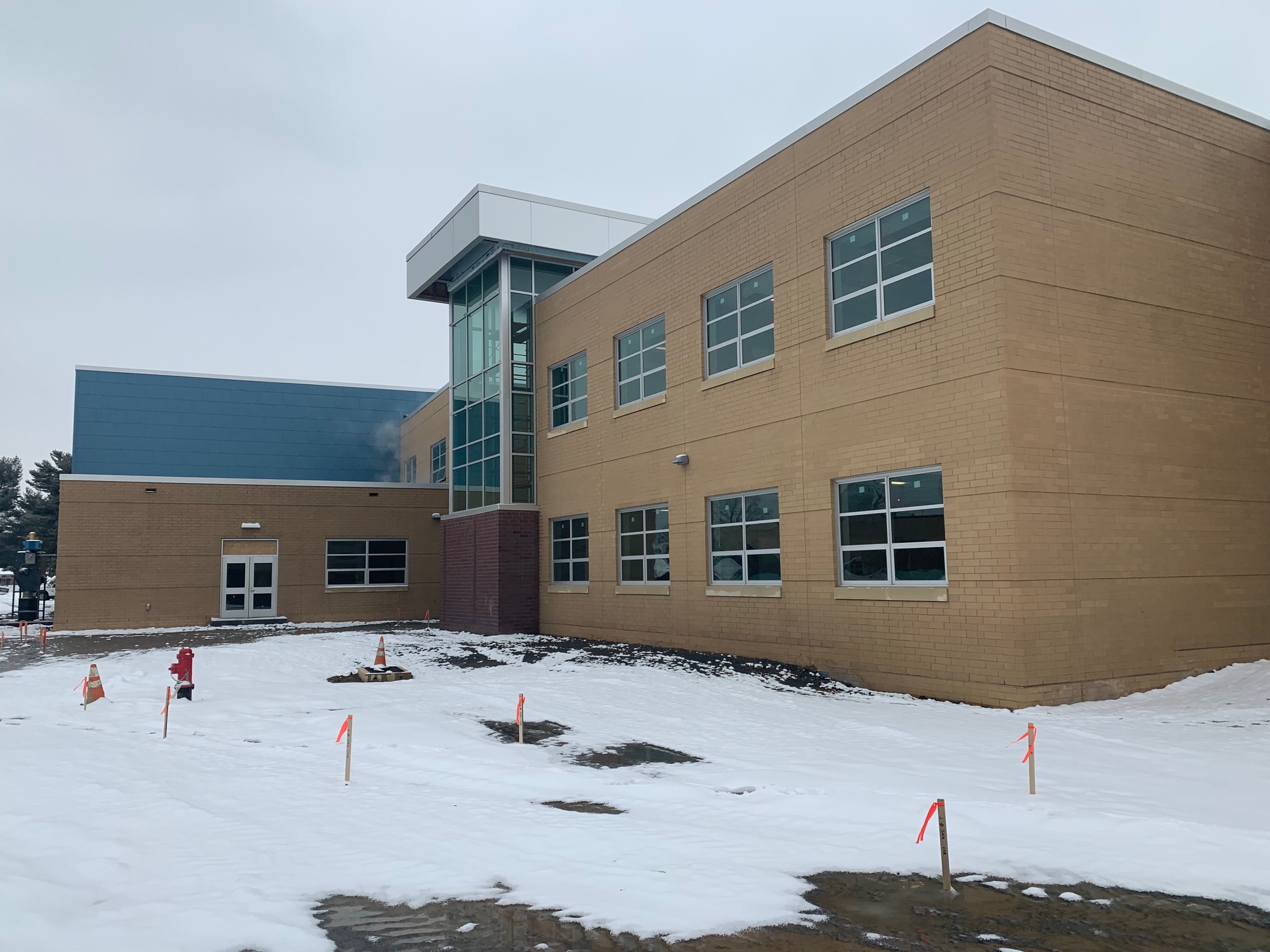

Spread Topsoil along west elevation

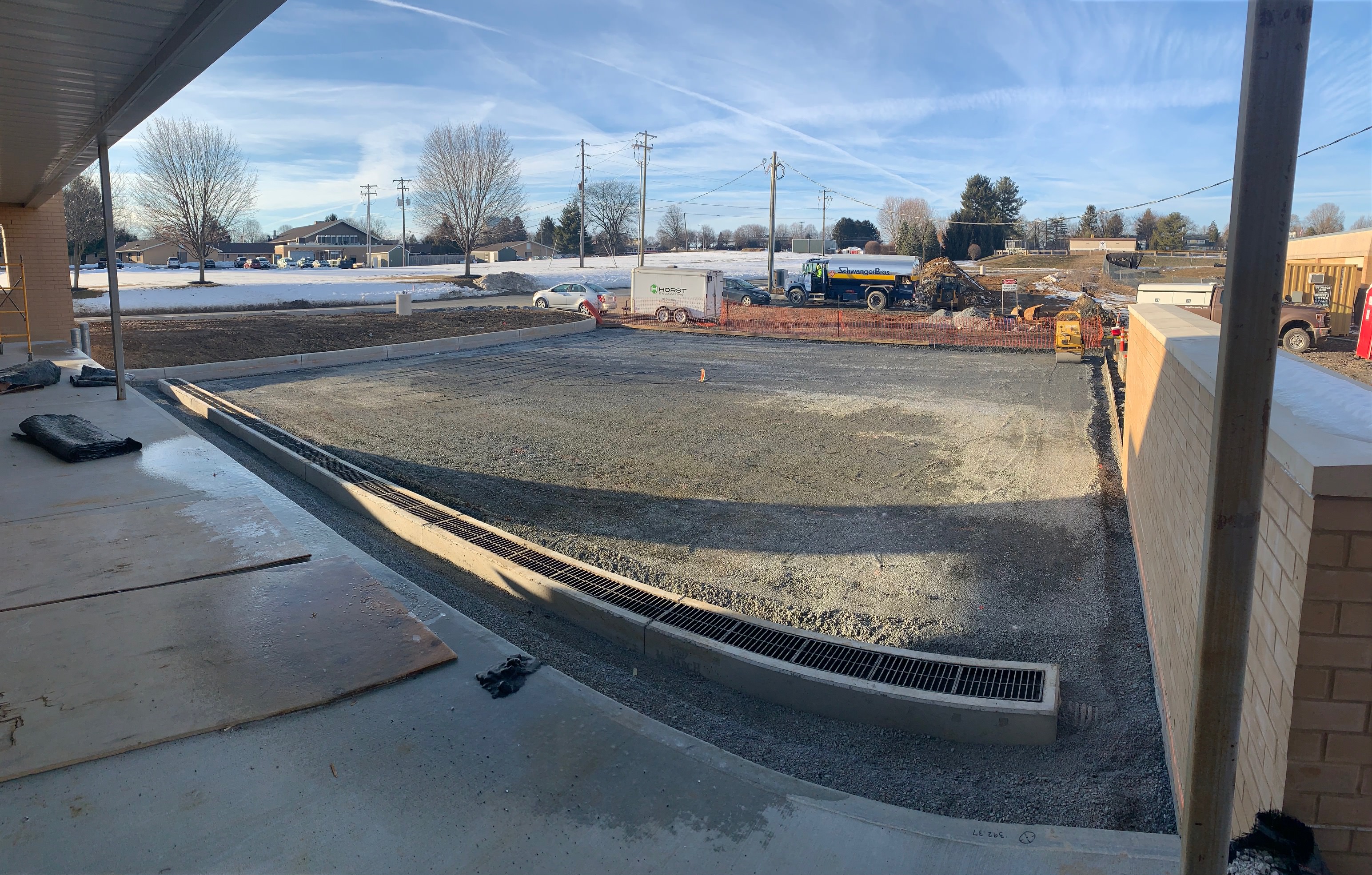

Prepared area in front of loading dock for concrete (next week weather permitting)
Began laying out for sidewalks along south elevation

GC

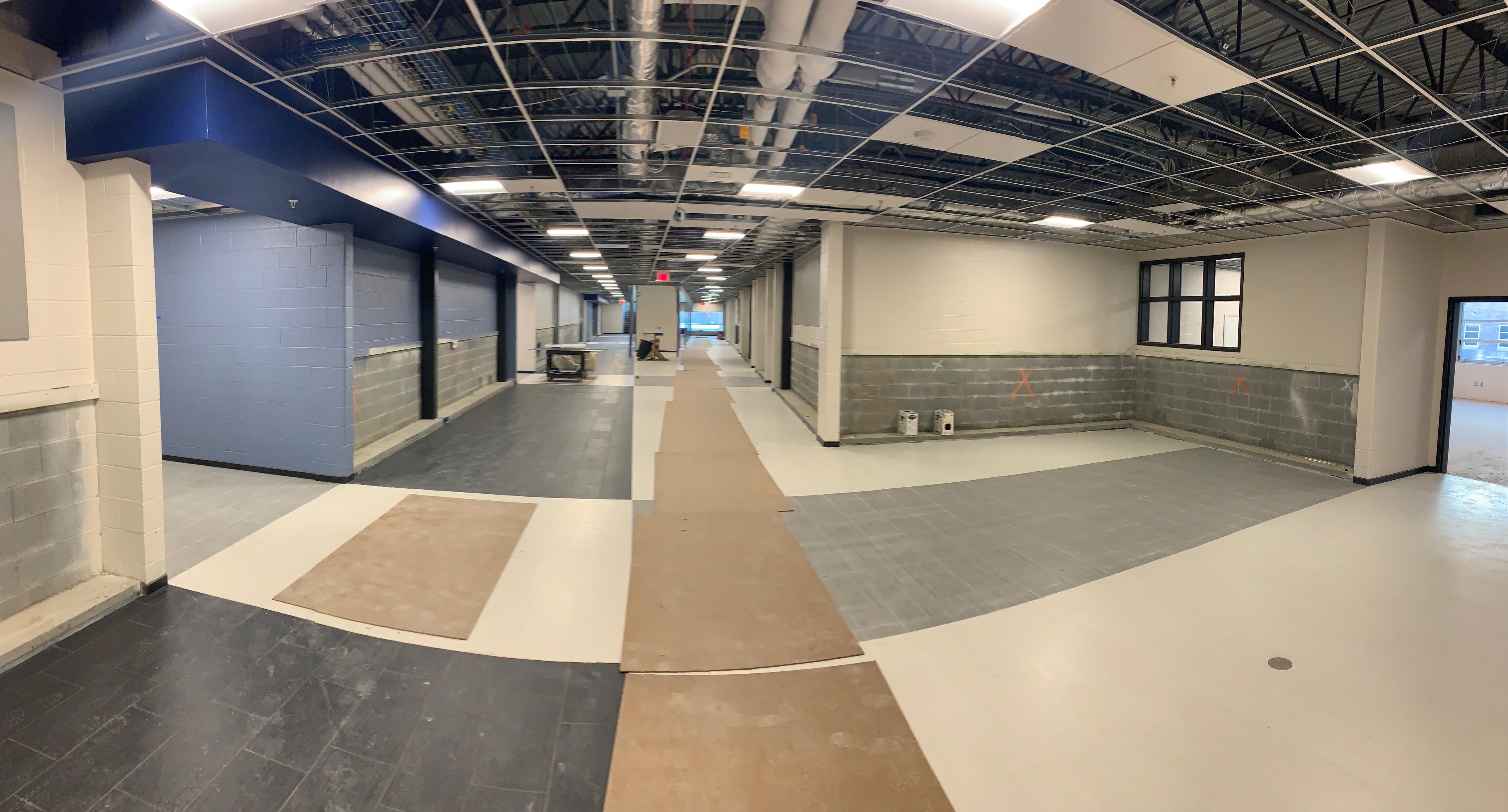

Completed installing ceramic floor tile in area F corridors & started in area E
Began grinding/polishing terrazzo in serving area

Plumber

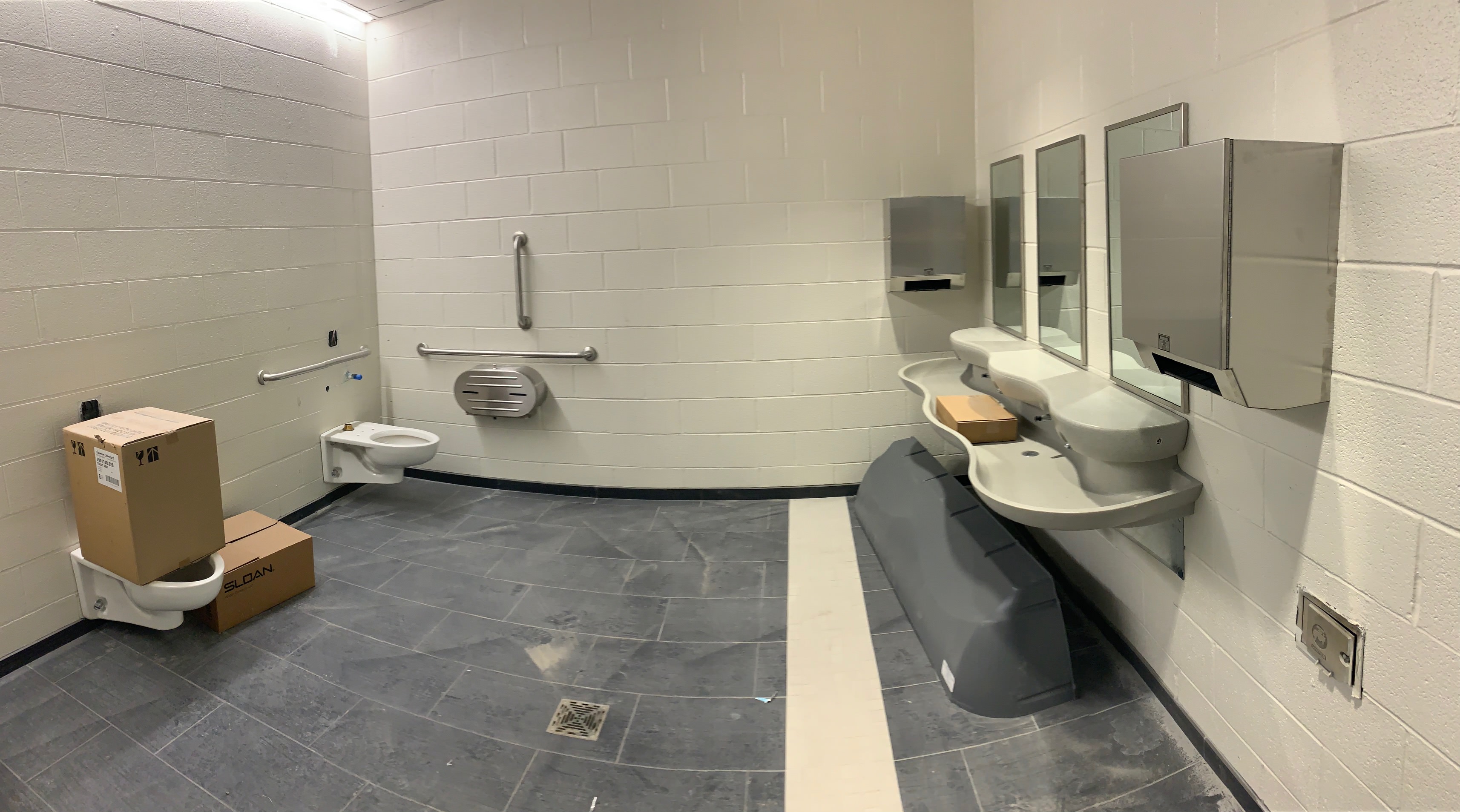

Continued setting toilets and sinks throughout the facility

Electrician
Finished installing lights in the corridors
Continued to terminate data wiring in IDF rooms
Continued installing outlets and switches throughout the facility

Mechanical
Started up the boilers and roof top HVAC units

Sprinkler
Continued installing sprinkler heads in ceiling tile as grid is being installed

Return to Table of Contents

Project Goals (for next month)

Complete ceiling tile installation in areas D, E & F
Complete first floor tile installation
Begin the installation of food service equipment
Start-up the permanent heating system in areas D, E and F
Pour concrete pad at loading dock
Pour concrete walks along the access drive (west elevation)
Begin carpet installation
Begin interior door installation

Return to Table of Contents

Did You Know?

The District is working with an auction company to sell many existing Middle School items that will not be reused before they turn the building over to the contractors for demolition.

Return to Table of Contents

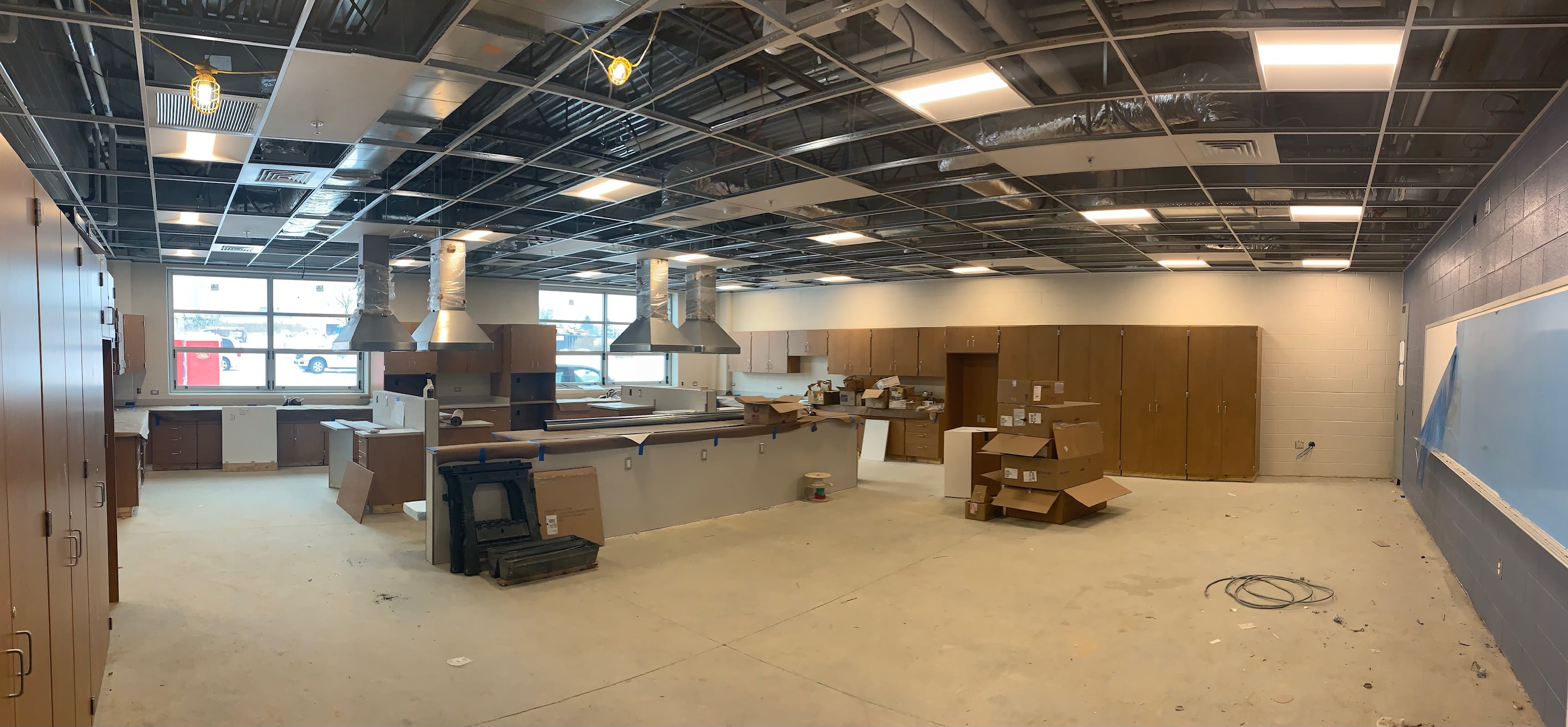

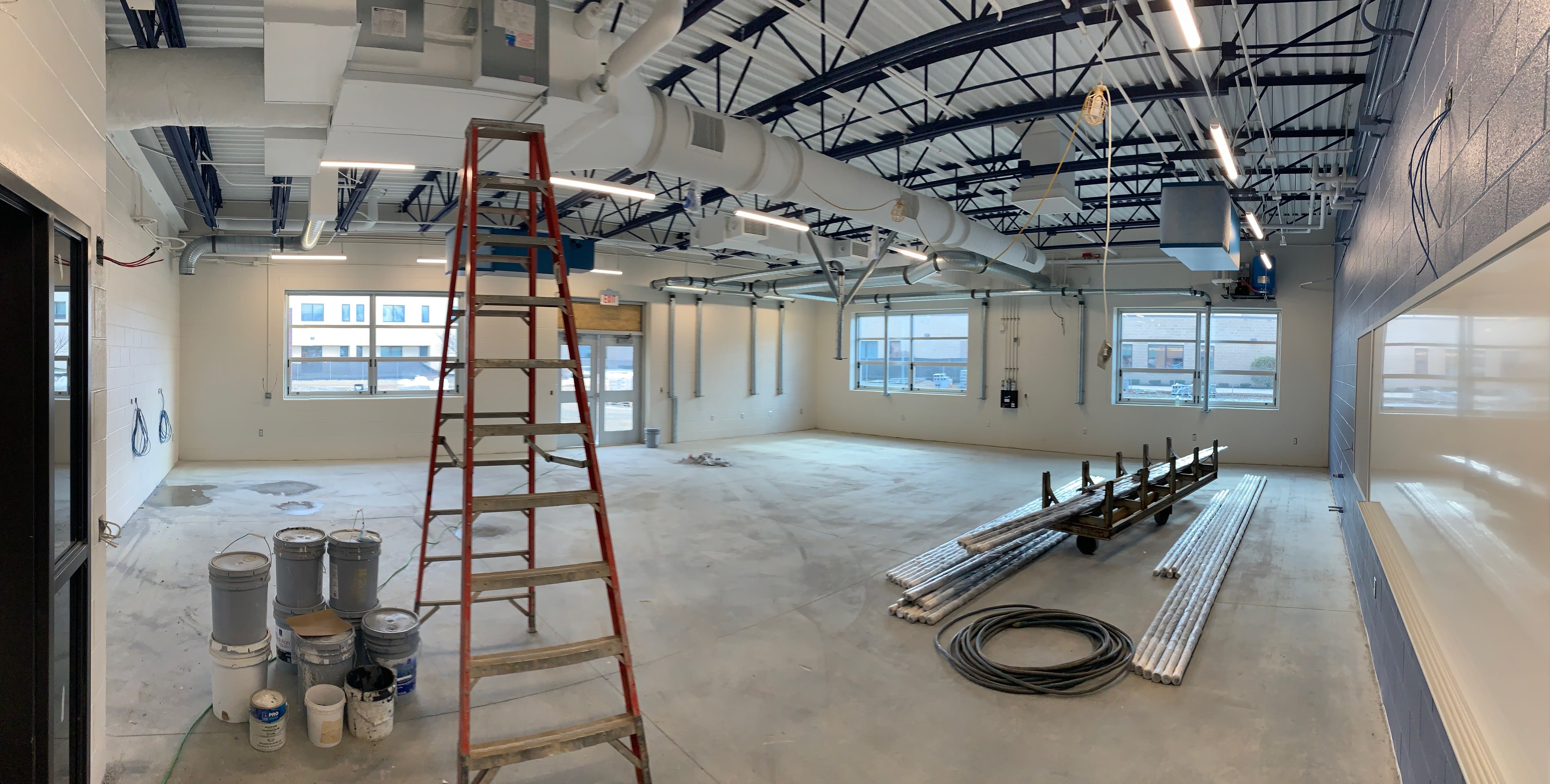

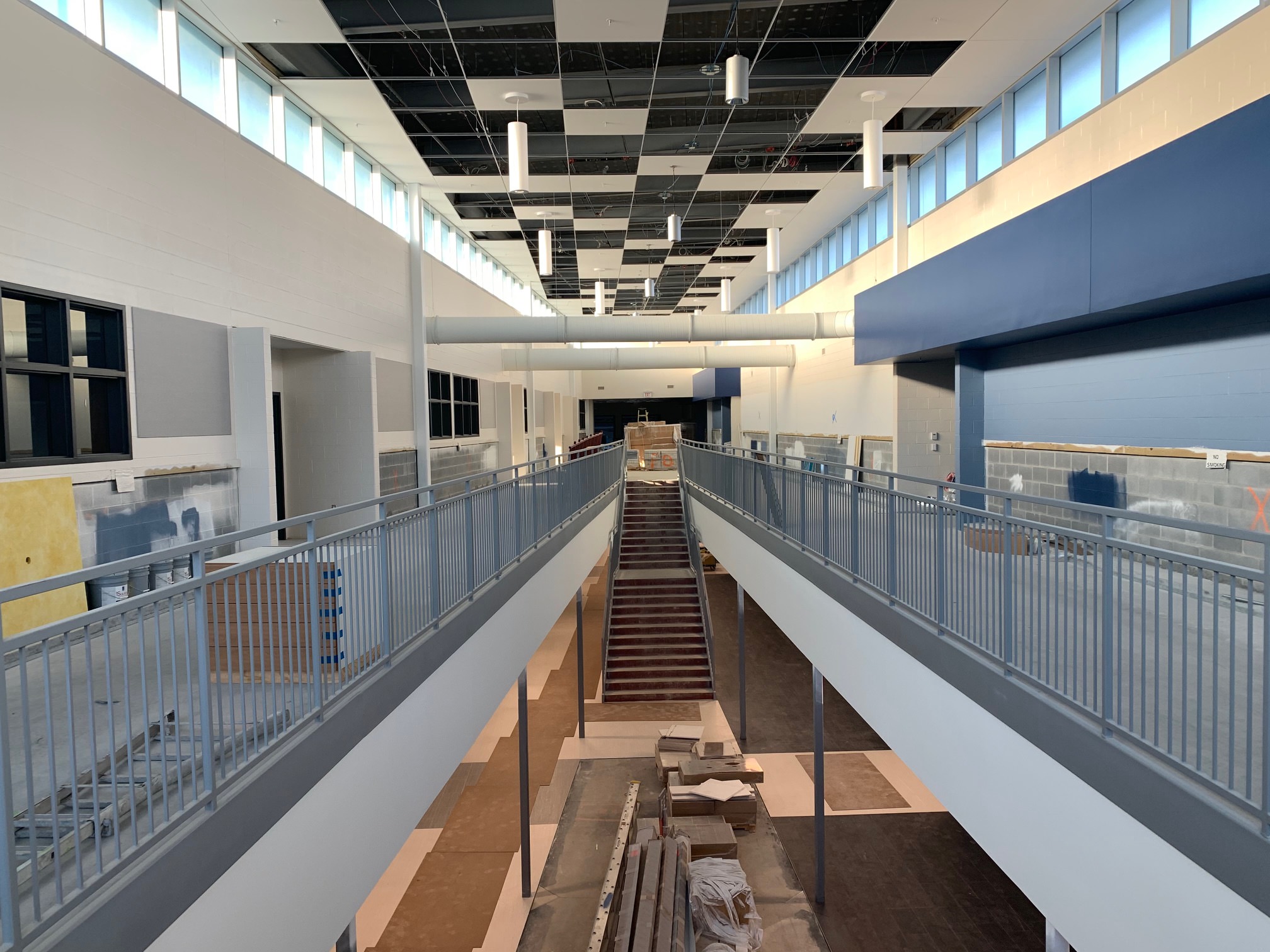

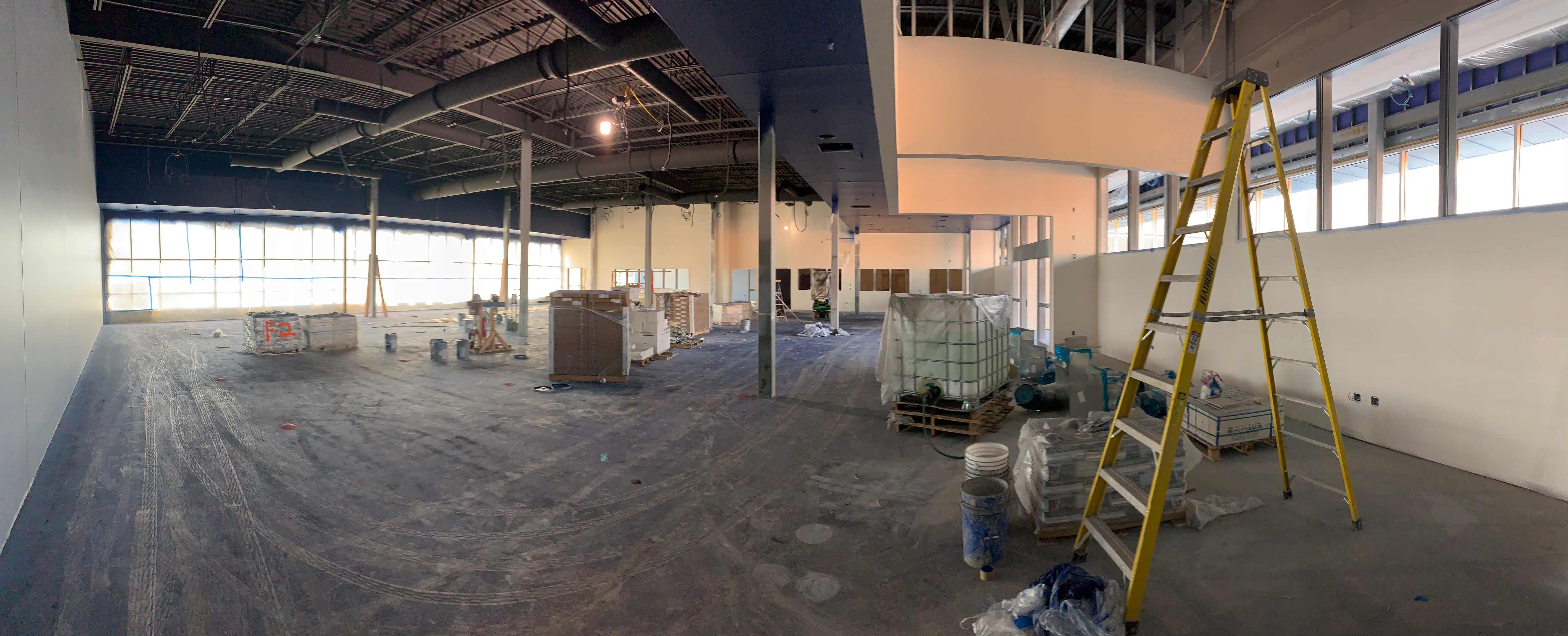

Return to Table of ContentsCourtyard - February 2021Area F - South Elevation - February 2021Area F - East Elevation - February 2021Area F Corridor - Upper Level - February 2021Area F Corridor - Lower Level - February 2021Gym - Divider Curtain - February 2021Scoreboard - February 2021Art Classroom - February 2021Technology Lab - February 2021Restroom - February 2021Area C - Drywall Under the Bridge - February 2021Food Lab - February 2021Art Classroom (Alt) - February 2021Loading Dock - Ready for Concrete - February 2021Typical Classroom - February 2021Library - February 2021Data Racks - February 2021Administration Office - February 2021Classroom Projector Mockup - February 2021[/cs_content_seo]
