March 2018
At the March 8, 2018, School Board Work Session, Mr. Jay Darkey, JPD Architects, LLC, provided an update regarding the campus site plans and timeline for the Middle School Construction project.
This construction project is a fluid process and the District is constantly evaluating what is in the best interest of the students. After an extremely detailed review of campus infrastructural needs and how construction will impact bus circulation, parent pick-up and drop-off, and the need for additional parking, it was confirmed during the March Work Session that the district needed to return to its original timeline of school opening in Fall 2021-2022 to provide for a less disruptive educational experience for the students and staff, and to allow the proper time for the District to transition into the new facility prior to the start of a school year.
Contents:
This construction project is a fluid process and the District is constantly evaluating what is in the best interest of the students. After an extremely detailed review of campus infrastructural needs and how construction will impact bus circulation, parent pick-up and drop-off, and the need for additional parking, it was confirmed during the March Work Session that the district needed to return to its original timeline of school opening in Fall 2021-2022 to provide for a less disruptive educational experience for the students and staff, and to allow the proper time for the District to transition into the new facility prior to the start of a school year.
Contents:

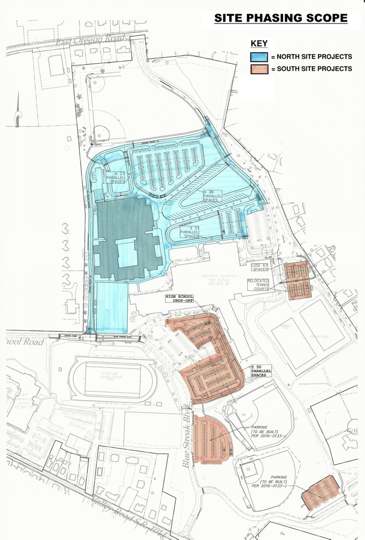

Site Project & Phasing Scope
NOTES:
NOTES:
- South Site Project
- 2 Parking Lots
- H.S. Drop-Off & Parking
- Tennis Court Relocation
- Bid May 2018
- North Site Project
- Middle School Project
- Bit Site Package July 2018
- Bid GC & MEP in September 2018

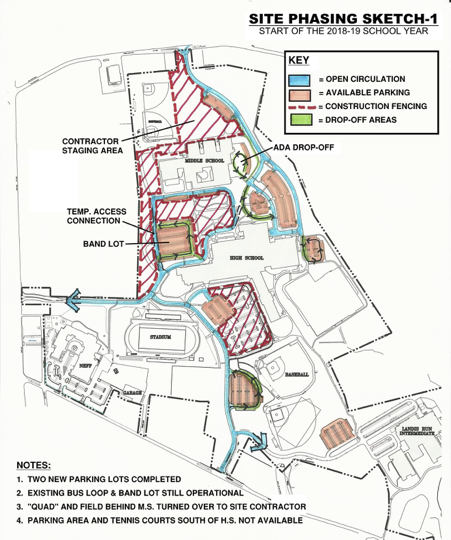

Start of 2018-2019 School Year
NOTES:
NOTES:
- Two New Parking Lots Complete
- Exist. Bus Loop & Band Lot Operational
- "Quad" & Field behind M.S. Not Available
- Parking & Tennis Courts South of H.S. Not Available

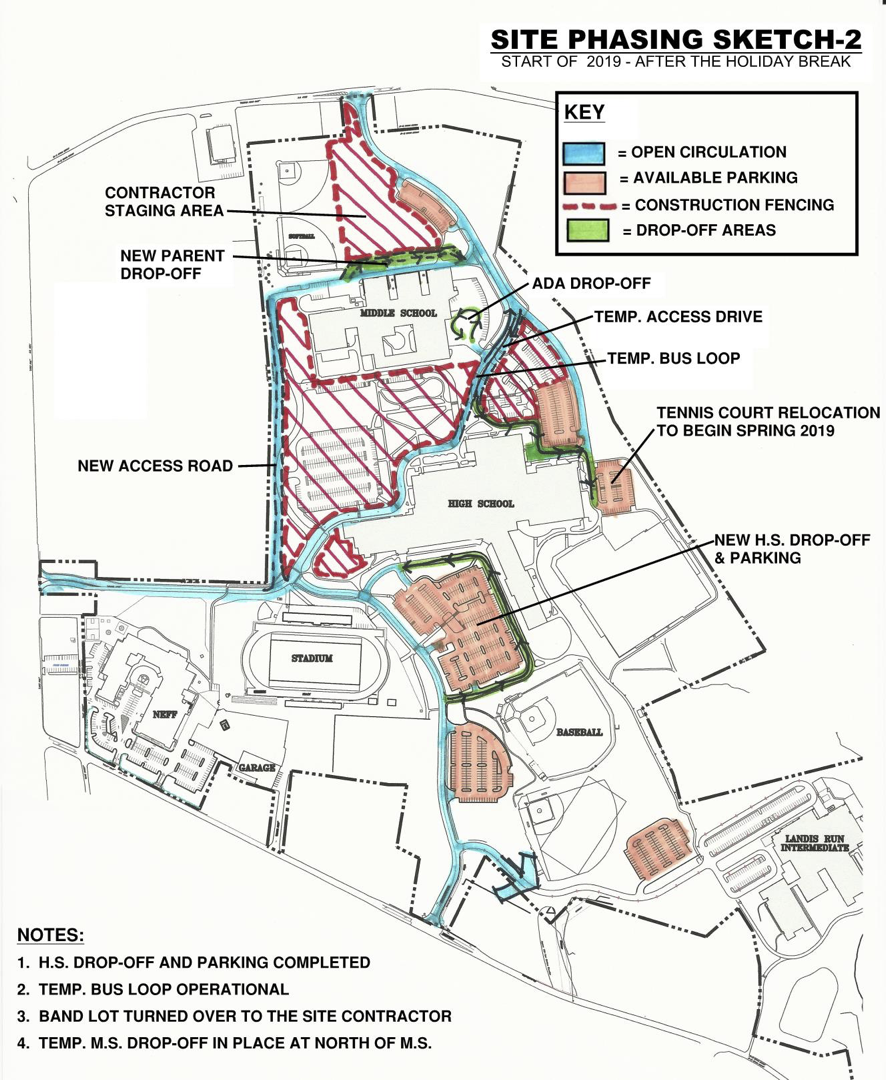

Start of 2019 - After Holiday Break
NOTES:
NOTES:
- H.S. Drop-Off & Parking Complete
- Temp. Bus Loop Operational
- Temp. Drop-Off Completed North of M.S.
- Band Lot Turn over to Contractors

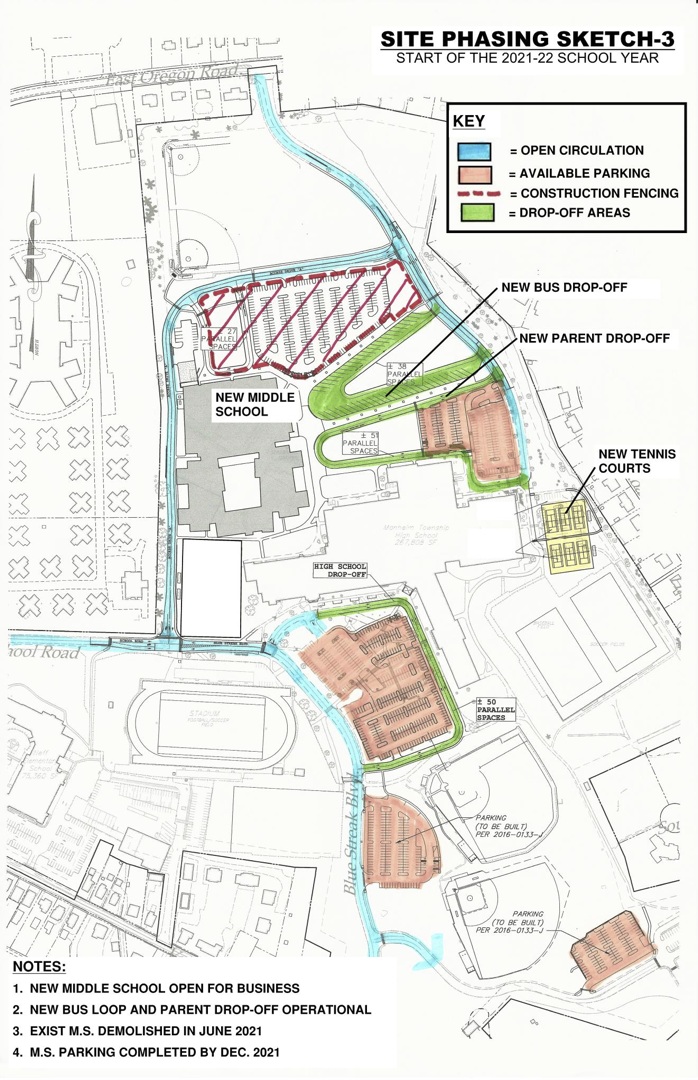

Start of 2021-2022 School Year
NOTES:
NOTES:
- New Middle School Open for Business
- New Bus Loop & Parent Drop-Off Operational
- Exist. M.S. Demolished in June 2021
- M.S. Parking Lot Completed by Dec. 2021
